All the latest:

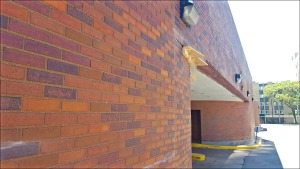

1. The exterior Tuckpointing and Masonry Repairs moved to the south driveway, adjacent to The Breakers.
Below, workers setting up for the day and waiting for the rain to pass; very little actually needs to be done along these locations, thanks to repairs last year following some leaking that affected the lighting. The purpose of their return, is to complete proactive tuckpointing where the mortar and masonry appear deteriorated.
The masonry team will continue and finish up along these locations weather permitting. They will move eastward toward the Southeast corner of the building where the project will be completed.
Work is expected to continue just about 2 more weeks or so, with continued cooperative weather.
2. The Planter Liner Replacement Project is entering its final phase.
Work was completed on the new liners, and our staff and planting volunteer (owner Kent Brave) met with landscapers to map out the plantings to be installed, irrigation and lighting.
There will be changes from the original plantings and layout. For the most part we know what worked and didn’t from before. But somethings will change do to climate and availability. And the layout will change to be more accommodating to the new plants being chosen.
The landscapers will return this week weather permitting and begin filling the planters back in. In the meantime, our team is preparing the materials for the new lighting and irrigation lines. We expect work will continue 4 to 5 more weeks.
3. The Security System Project continued with cameras being installed throughout the entire 1st level of the building, in the mall, driveway and lobby. In the coming week they expect to finish the first level of the building, and to begin working on wiring and devices for the 2nd floor locations.
They have also started integrating the new software. Management is working with the contractor to audit the fob database. The information in our current fob system is compatible, but we are using the opportunity to audit every fob and clean up the data. We have opted for a “better safe than sorry” approach, once the new server goes live, it is possible some residents will have had their fob deactivated. We will be sure to post and e-mail announcements when this turnover is scheduled so all residents and owners have a heads up. And, we will be ready to make any updates and corrections as we become aware of any problems.
4. The Health Club Locker Room and Bathroom Remodeling Project build out continued.

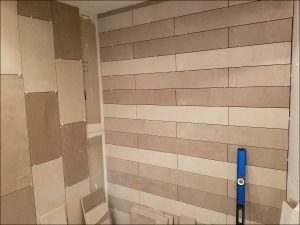

Tile work continued, with most the walls throughout the locker room in place and flooring in progress. Work got underway in the bathrooms:
This week, the build out inside the locker rooms will continue with tile installation on the floors, walls in the bathrooms, columns and in the showers. Following that, in coming weeks expect the installation of new faucets, sinks and toilets, as well as the new dry saunas.
5. The project for Replacement of the Pool Liner is still expected to begin the at the end of the month. We had expected installation to begin last week. Unfortunately, an unknown condition resulted in the need for special parts to be manufactured.
Click here for more details on the delay!
Barring any further surprises or the discovery of as of yet unknown conditions, the team hopes to begin the week of July 31st. Should all go well, the pool would be back up and running by the end of August.
Unfortunately due to their interconnection, both the Main Pool and the Kiddie Pool will be closed during this process.
6. Replacement of the Garage Fire Doors is now underway. Complications while removing the existing fire doors on 2p, overnight July 7th, lead us to believe the work will take up to a couple extra nights to complete.
Work will continue Saturday night, July 8th, as they finish up on 2p. With luck they will move up and begin work on 1p, and may need to continue Sunday and Monday night to finish up.
While their casings were replaced about 9 years ago, and appear to be in good condition (pictured below), the actual doors enclosed are very old and have not consistently performed well during recent testing and inspections, at least not to our satisfaction.
The bulk of this work is being done at night in order to minimize inconvenience to parkers.
From time to time as workers are bringing the old materials down and putting the new doors in place, traffic will be hampered coming and going through these thresholds.
If you have questions or concerns about this, please e-mail Marlon in the office, at m.dacres@dkcondo.com.
7. At the June 12th Board Meeting, the Board acted on the planned Main Roof Replacement Project. Berglund Construction Company was chosen, and we expect to formally award them the project in the next couple days.
The final contract with the General Contractor has been negotiated, and preliminary preparations are underway. We are beginning steps to get the permits needed and the contractor will be ordering materials. Very tentatively, we would expect physical preparations to the roof to begin in mid to late August with demolition following in September. Deck and masonry repairs and installation of the new insulation and roof membrane would take place between September and November.
The BAD NEWS – this project will be messy and will tie up the service elevators as the old roof and waste materials come down and new materials are taken up. We will be working out a schedule with the contractor so they are using the elevator at the least inconvenient windows of time, and try to have this mapped out in advance so residents are able to plan ahead.
The WORSE NEWS – window washing will not take place again for several months – probably not until late October or November. Due to the new OSHA rules regarding how workers can be anchored to the building as they do their job, we are unable to have equipment or human beings tied off from our roof. Results from the engineering report connected with the roof project showed we do not have a system in place that is compliant enough with the new OSHA regulations. So, we are essentially prohibited from doing the window washing at this time.
Above, the roof before we begin work. The study performed by Wiss Janney Elstner showed our structural deck appears to be in good shape, but the insulation under the roof membrane is pretty well shot and saturated with moisture.
There is GOOD NEWS – or at least an optimistic view to work such as this. Care and replacement of the roof system is one of the most important jobs that needs to be planned in the life cycle of a building such as Park Tower. A new roof helps protect the building from water infiltration. Also, new insulation, particularly in these locations, could save quite a bit of energy. While this is a big and relatively expensive undertaking with little aesthetic benefit to residents and owners, it is very positive that PTCA is able to map this project out and get the work done with funding from the present Reserve.
While the Board has had to devote more dollars to install the new Anchorages, so work such as the window washing and other exterior repairs can be done in the future, the timing could not be better. Despite spending more dollars than expected, the Association is saving money by having them both done at the same time.
All the latest:

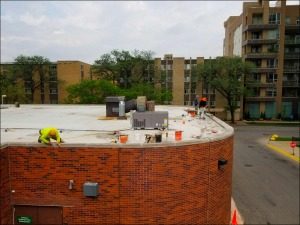

1. The last stretch of the exterior Tuckpointing and Masonry Repairs, along the North driveway, got underway right on schedule. Next week, weather permitting, they will be completely finished in this location.
Above, workers begin repairs to the inner side of the wall along the West end of the driveway.
The masonry team will continue and finish up along these locations weather permitting. Then they will relocate to the driveway between PT and The Breakers.
This project should continue just about 3 more weeks or so, with continued cooperative weather.
2. The Planter Liner Replacement Project will enter it’s final phase following the week of 4th of July.
Work was completed on the new liners:
Above, the completed liner in the East deck circular planter. Below, the completed planter along the North wall of the roof deck:
The liners were finished somewhat ahead of what we anticipated, and very fortunately we have not needed to close the deck as we anticipated we might.
The landscapers are not expected to return until the week of July 10th, to begin filling them back in. In the meantime, our team is preparing the materials for the new lighting and irrigation lines.
3. The Security System Project continued with new lines and cameras being installed throughout the entire 1st level of the building, including the mall, dock, back driveway and lobby. We’ve been told to continue to expect workers in the mall area, lobby, and front driveway. They will also begin working on wiring and devices for the 2nd floor locations.
Above, new cameras in the dock area. Below, new cameras at the middle mall intersection.
4. The Health Club Locker Room and Bathroom Remodeling Project build out continued.
Walls have been closed up and the tile work is well underway:
In the coming week, the build out inside the locker rooms will continue with tile installation on the floors, walls, columns and in the showers. Following that, we expect the installation of new fixtures including faucets, sinks and toilets, as well as the new dry saunas.
5. The project for Replacement of the Pool Liner hit a snag. We expected installation to begin this week. Undoubtedly members noticed there have been no workers and no progress. Unfortunately, an unknown condition is resulting in the need for special parts to be manufactured:
Click here for more details on the delay!
Barring any further surprises or the discovery of as of yet unknown conditions, the team hopes to begin the week of July 31st. Should all go well, the pool would be back up and running by the end of August.
Unfortunately due to their interconnection, both the Main Pool and the Kiddie Pool will be drained for this process.
6. Replacement of the Garage Fire Doors was approved, to bring them up to current code. And the work is not tentatively scheduled to take place overnight Friday July 7th and Saturday July 8th.
While their casings were replaced about 9 years ago, and appear to be in good condition (pictured below), the actual doors enclosed are very old and have not consistently performed well during recent testing and inspections, at least not to our satisfaction.
The contractor hired to do this work has advised us materials are arriving for the project, and we are looking at the work being done overnight on July 7th and 8th. The bulk of this work will be done at night in order to minimize inconvenience to parkers. We plan to post notices with the dates and times, so residents know what to expect when they are coming and going from the garage when work is underway.
From time to time as workers are bringing the old materials done and putting the new doors in place, there may be delays as parkers are coming and going through these thresholds. If you have questions or concerns about this, please e-mail Marlon in the office, at m.dacres@dkcondo.com.
7. At the June 12th Board Meeting, the Board acted on the planned Main Roof Replacement Project. Berglund Construction Company was chosen, and we expect to formally award them the project in the next couple days.
The final contract with the General Contractor has been negotiated, and preliminary preparations are underway. We are beginning steps to get the permits needed and the contractor will be ordering materials. Very tentatively, we would expect physical preparations to the roof to begin in mid to late August with demolition following in September. Deck and masonry repairs and installation of the new insulation and roof membrane would take place between September and November.
The BAD NEWS – this project will be messy and will tie up the service elevators as the old roof and waste materials come down and new materials are taken up. We will be working out a schedule with the contractor so they are using the elevator at the least inconvenient windows of time, and try to have this mapped out in advance so residents are able to plan ahead.
The WORSE NEWS – window washing will not take place again for several months – probably not until late October or November. Due to the new OSHA rules regarding how workers can be anchored to the building as they do their job, we are unable to have equipment or human beings tied off from our roof. Results from the engineering report connected with the roof project showed we do not have a system in place that is compliant enough with the new OSHA regulations. So, we are essentially prohibited from doing the window washing at this time.
Above, the roof before we begin work. The study performed by Wiss Janney Elstner showed our structural deck appears to be in good shape, but the insulation under the roof membrane is pretty well shot and saturated with moisture.
There is GOOD NEWS – or at least an optimistic view to work such as this. Care and replacement of the roof system is one of the most important jobs that needs to be planned in the life cycle of a building such as Park Tower. A new roof helps protect the building from water infiltration. Also, new insulation, particularly in these locations, could save quite a bit of energy. While this is a big and relatively expensive undertaking with little aesthetic benefit to residents and owners, it is very positive that PTCA is able to map this project out and get the work done with funding from the present Reserve.
While the Board has had to devote more dollars to install the new Anchorages, so work such as the window washing and other exterior repairs can be done in the future, the timing could not be better. Despite spending more dollars than expected, the Association is saving money by having them both done at the same time.
A lot of work going on inside and outside of Park Tower….here is all the latest:
1. The exterior Tuckpointing and Masonry Repairs continued moving forward and we are relatively on track with the anticipated timing, despite some bumpy weather this week. The team worked along the inner side of the North wall and around the garage entrance. Next week, weather permitting, they will continue moving along this wall and into the market dock area.
The focus of this work continues to be basic repairs to the masonry and installation of new flashing above vents and doors and under copings at the top of the walls.

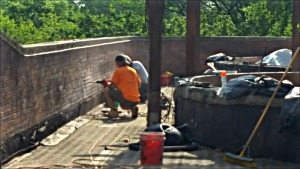

Above, workers begin repairs to the inner side of the wall along the driveway, just outside the main pool structure. Below, they are installing new flashing under the coping stones.
The masonry team will continue and finish up along these locations weather permitting, and move westward through the driveway each work day. This project should continue just under 4 more weeks or so, with a continued cooperative weather pattern.
2. The Planter Liner Replacement Project is now underway.
Work continued in the planters being relined on the roof deck. The workers completed removal of the soil and plants, and placed protection over the piles of dirt to prevent excess dust and mud should it rain.
Below, workers are repairing deteriorated masonry along the sidewalls of the North planter:
Also this week, we held a meeting with the landscaping team who is using the original design plans when the planters were first put in, to devise the layout for new bushes, flowers and trees. They advised that due to availability, some of the original plantings can not be replaced. Also, changes in the climate over the past couple decades and other variables mean we will have to make a handful of other considerations for alternates. Our engineer and plumber also devised a preliminary plan for the installation of the new irrigation and electrical lines.
As this project gets underway, we expect there may be times the roof deck may not be accessible. So far, we have been able to avoid any closures because the piles of dirt have been smaller than we anticipated. Should we need to close this area at all, we do plan to allow access to the sun deck adjacent to the pool area, for sun bathers and other residents who want to access the deck.
Above is an aerial view of the work underway, provided by Unit Owners Edmund Jaeger and Kevin O’Rourke.
3. The Security System Project continued with new lines and conduit being installed. Most of the work has been in fairly isolated locations in the garage and under the pool. But workers are closing in on locations within the mall, where new conduit will feed the security cameras at each doorway in and out of Park Tower, and the middle intersection. They will continue installing the new network lines and drilling in locations where pipe needs to be embedded or anchored.
We’ve been told to expect workers will be in the mall area, the service area and by the residential elevators next week, pulling wires. They will be pulling down the can lights fishing wires through to the various camera locations. Some drilling may take place from time to time. Below is one location new wiring will be pulled to, to service a replacement camera:
We expect them to be working throughout the next few weeks in locations throughout the mall, lobby and 2nd floor.
4. The Health Club Locker Room and Bathroom Remodeling Project build out continued.

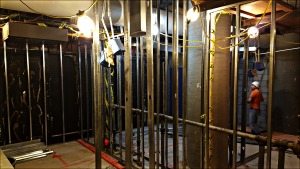

Plumbing work got underway in earnest, and the bulk of the new lines, drains and valves have been put in place. The water lines have been tested and appear to be ready for the new fixtures that will be brought in and installed in a few weeks.
Above, the new plumbing was charged and tested. Below, the new men’s locker room shower basin and drain is in place. Valves were installed to prepare for the fixtures to come.
Below, workers also began running replacement electrical lines and mechanical fixtures; in this picture, the boxes for the exhaust fans have been put in place:
Some have noticed small changes in the hallway, as we adjusted the size and shape of the men’s locker room to accommodate the remodeling plans. At the bend in the hallway, we previously had about 58″ between one wall and the other. Now there is 52″. Still wide enough to accommodate passage, of course. Thanks to this, we were able to squeeze about 10 more square feet of space into the men’s locker room.
In the coming week, the build out inside the locker rooms will continue and major plumbing work will be completed. Installation of new electrical lines and conduit will continue. Following that in coming weeks, work will get underway on drywall, tiling walls and floors, and installing new fixtures and finishes.
There is a Health Club Committee Meeting Monday June 19th at 5pm in the Party Room if any owners or members are interested in learning more.
5. The project for Replacement of the Pool Liner begins this weekend, with the pool being drained Saturday June 17th at 9pm. The contractor and manufacturer will begin inspecting the inside surface of the pool Monday June 19th, and begin making plans to prepare the surface for installation of the new PVC liner.
Barring any surprises or the discovery of unknown conditions, the team hopes to begin actual preparations over the next week, with hope the liner will begin being installed on Monday June 26th. If all goes smoothly, it would take about 3 weeks, after which we could begin filling and heating the pool to put it back in service. With luck, the pool could be open before the end of July. A lot will depend on what the team finds when they inspect the week of Monday the 19th – so we should have a better idea with our updates after that time.
Unfortunately due to their interconnection, both the Main Pool and the Kiddie Pool will be drained for this process.
6. Replacement of the Garage Fire Doors was approved, to bring them up to current code. And the work is not tentatively scheduled to take place overnight Friday July 7th and Saturday July 8th.
While their casings were replaced about 9 years ago, and appear to be in good condition (pictured below), the actual doors enclosed are very old and have not consistently performed well during recent testing and inspections, at least not to our satisfaction.
The contractor hired to do this work has advised us materials are arriving for the project, and we are looking at the work being done overnight on July 7th and 8th. The bulk of this work will be done at night in order to minimize inconvenience to parkers. We plan to post notices with the dates and times, so residents know what to expect when they are coming and going from the garage when work is underway.
From time to time as workers are bringing the old materials done and putting the new doors in place, there may be delays as parkers are coming and going through these thresholds. If you have questions or concerns about this, please e-mail Marlon in the office, at m.dacres@dkcondo.com.
Indirectly associated with this work will be the Replacement of the Back Dock Double Doors and Frame.
Above, this location also has an emergency fire door which is original to the building, and not presently operational. Below, once this is in place, the team conducting masonry repairs will complete the tuckpointing, brick replacement and flashing above the door.
7. At the June 12th Board Meeting, the Board acted on the planned Main Roof Replacement Project. Berglund Construction Company was chosen, and we expect to formally award them the project in the next couple days.
If all goes as expected, preparations will begin as soon as next week. We will begin taking steps to get the permits needed and the contractor will order materials. Very tentatively, we would expect physical preparations to the roof to begin in mid to late August with demolition following in September. Deck and masonry repairs and installation of the new insulation and roof membrane would take place between September and November.
The BAD NEWS – this project will be messy and will tie up the service elevators as the old roof and waste materials come down and new materials are taken up. We will be working out a schedule with the contractor so they are using the elevator at the least inconvenient windows of time, and try to have this mapped out in advance so residents are able to plan ahead.
The WORSE NEWS – window washing will not take place again for several months – probably not until late October or November. Due to the new OSHA rules regarding how workers can be anchored to the building as they do their job, we are unable to have equipment or human beings tied off from our roof. Results from the engineering report connected with the roof project showed we do not have a system in place that is compliant enough with the new OSHA regulations. So, we are essentially prohibited from doing the window washing at this time.
Above, the roof before we begin work. The study performed by Wiss Janney Elstner showed our structural deck appears to be in good shape, but the insulation under the roof membrane is pretty well shot and saturated with moisture.
There is GOOD NEWS – or at least an optimistic view to work such as this. Care and replacement of the roof system is one of the most important jobs that needs to be planned in the life cycle of a building such as Park Tower. A new roof helps protect the building from water infiltration. Also, new insulation, particularly in these locations, could save quite a bit of energy. While this is a big and relatively expensive undertaking with little aesthetic benefit to residents and owners, it is very positive that PTCA is able to map this project out and get the work done with funding from the present Reserve.
While the Board has had to devote more dollars to install the new Anchorages, so work such as the window washing and other exterior repairs can be done in the future, the timing could not be better. Despite spending more dollars than expected, the Association is saving money by having them both done at the same time.
Progress continued this week…
The exterior Tuckpointing and Masonry Repairs continued moving forward and we are right on track with the anticipated timing. They worked along the North wall and around the garage entrance. Next week, weather permitting the team will continue moving along the wall and into the market dock area.
The focus of this work continues to be basic repairs to the masonry and installation of new flashing above vents and doors and under copings at the top of the walls.
In the above picture, braces were put in place to help steady an area of repair work while the mortar cures.
The masonry team will continue and finish up along these locations weather permitting, and move westward through the driveway each work day. This project should continue about 4 more weeks or so, with a continued cooperative weather pattern.
2. The Planter Liner Replacement Project is now underway.
The process began with emptying of the target planters, which are along the north side of the deck. All the plant material was removed, including the perennial flowers and trees.
Above, prep work can now begin to reline the large planter along the North wall of the roof deck.
Above, dirt is removed and the tree is prepped for removal. With landscapers telling us the trees are too big for our planters, and with no practical way to save them, sadly they were pruned of their limbs and removed piece by piece.
As this project gets underway, we expect there may be times the roof deck will not be accessible. We do plan to allow access to the sun deck adjacent to the pool area, for sun bathers and other residents who want to access the deck.
3. The Security System Project is continuing with new lines and conduit being installed. Workers are closing in on locations within the mall, where new conduit will feed the security cameras at each doorway in and out of Park Tower, and the middle intersection. They continued installing the new network lines and drilling in locations where pipe needs to be embedded or anchored.
Overall, with the exception of drilling noise from time to time, their presence will continue to be minimally invasive. You may notice workers in random locations – for the most part where we already have cameras and fob swipe pads – installing conduit and wiring. In coming weeks, this is expected to include the mall, lobby and 2nd floor.
4. The Health Club Locker Room and Bathroom Remodeling Project build out continued and the framing work is about finished. Plumbing work got underway in earnest, and preparations continued to run new electric lines.
Above, the old plumbing stands ready to be cut out and replaced. Below, framing is completed in the location for the new men’s locker room shower.
You may notice some small changes in the hallway, as we adjusted the size and shape of the men’s locker room to accommodate the remodeling plans. We have been able to squeeze about 10 more square feet of space into the locker room.
In the coming week, the build out inside the locker rooms will continue and major plumbing work will be completed. Preparations will get underway for installation of new electrical lines. Following that in coming weeks, work will get underway on drywall, tiling walls and floors, and installing new fixtures and finishes.
5. We continue to expect the project for Replacement of the Pool Liner to begin by the end of June, or at the latest, the beginning of July. We expect materials to start arriving throughout the month of June, followed closely by the contractor. We’ve been told to expect the pool to be closed for about 4 weeks as this project is completed.
We are hoping within the next week or two to have a definitive start date.
6. Replacement of the Garage Fire Doors was approved, to bring the fire doors up to current code. While their casings were replaced about 9 years ago, and appear to be in good condition (pictured below), the actual doors enclosed are very old and have not consistently or sufficiently performed optimally during recent testing and inspections, at least not to our satisfaction.
The contractor hired to do this work has advised us materials are arriving for this project, and we are looking at begin in early July. The bulk of this work will be done overnight to minimize inconvenience to parkers. We plan to post notices with the dates and times, so residents know what to expect when they are coming and going from the garage when work is underway.
Indirectly associated with this work will be the replacement of the back dock double doors and frame. This to has an emergency fire door, which is original to the building, and not presently operational.
7. Plaster Repairs to the Canopy in front of the building, right under the corner behind the doorman, were completed. This area was damaged in high winds during a storm this past Spring.
Work continues in several locations throughout Park Tower, while we are gearing up to begin work in others. This years budget calls for just over $2Million in work to be done, inside and out, from the main roof all the way at the top of Park Tower, down to the Parking Garage. Literally and figuratively from top to bottom.
Owners and residents can see PTCA’s reserve dollars at work making these needed repairs and improvements.
1. The Tuckpointing and Masonry Repairs continued in the vicinity of the back dock and driveway. Solid progress has been made thanks to the relatively cooperative weather. The focus of this work includes repairs to the masonry and installing new flashing above vents and doors and under copings at the top of the walls.
The primary areas which were problematic along these walls were obvious, anytime it rained. And leaking would occur from time to time in some of the adjacent mall offices.
In the above picture, evidence of water infiltration is clear from the stained mortar lines, adjacent to the vent and across the entire length of this wall, located in the dock area.
Pictured above, workers make masonry repairs and install flashing above the Commercial Cooling Tower air intake vent; and below repairs have been completed above and around the large vent, on the wall along the south side of the dock.
The masonry team will continue and finish up along these locations weather permitting, and continue northward through the driveway over the next couple weeks. Eventually they will move around the corner and begin working along the north wall and garage entrance. This project should continue about 6 more weeks or so, weather permitting.
2. The Planter Liner Replacement Project is anticipated to begin on Thursday June 1st. We received the necessary repair permits this week.
The process will begin with landscapers emptying out the target planters, which are along the north side of the deck. This includes removal of all the plant material such as the perennial flowers and trees. We are relocating a few of the perennials, but very sadly most of our plantings including the trees will not be saved.
Not only is there no practical way for the tree (above) to survive the liner replacement process, it has reached a size that is not very good for our planters or the roof over this location. It will be cut down and removed.
As this project gets underway, there will be times the roof deck will not be accessible. We are working on a plan to allow access to the sun deck adjacent to the pool area, for sun bathers and other residents who want to access the deck. More information will be available as we get underway and know better what to expect, and what exactly will be possible to accommodate.
3. The Security System Project is continuing with new lines and conduit being installed. Workers began in earnest with locations in the garage. They are installing the new network lines and drilling in locations where pipe needs to be embedded or anchored. Overall, with the exception of drilling noise from time to time, their presence is minimally invasive. You may notice workers in random locations – for the most part where we already have cameras and fob swipe pads – installing conduit and wiring.
4. The Health Club Locker Room and Bathroom Remodeling Project demolition is completed! Framing is underway for new walls, with preparations being made for all new plumbing and electrical lines to be installed.
Old walls and frames were taken down (above); new framework is being put in place to hang new drywall and anchoring for fixtures (below).
In the coming week, work will be done in the hallway leading out to the pool. We expect the hallway to be closed on Wednesday May 31st, as the construction team replaces the framing of the perimeter of the locker rooms. However, we will set up a detour through the Party Room so members can still access the pool. Also, we ordered a changing tent, to make it easier for members to get changed into and out of of their swim attire. We expect this to be delivered any day and it should be installed sometime over the Memorial Day weekend.
In the coming weeks, all new plumbing and electrical lines will be installed, and work will get underway installing walls, fixtures and finishes.
5. Replacement of the Pool Liner is expected to begin by the end of June, or at the latest, the beginning of July. Most recently, this project has been at the mercy of the weather, as the team working on our project has outdoor pools ahead of us on their schedule. We expect materials to start arriving throughout the month of June, followed closely by the contractor. We’ve been told to expect the pool to be closed for about 4 weeks as this project is completed.
6. Replacement of the Garage Fire Doors was approved, to bring the fire doors up to current code. While their casings were replaced about 9 years ago, and appear to be in good condition (pictured below), the actual doors enclosed are very old and have not consistently or sufficiently passed recent testing and inspections to our satisfaction.
The contractor hired to do this work has advised us materials have begun arriving, and we should be getting an anticipated schedule of work within in the next couple weeks. The bulk of this work will be done overnight to minimize inconvenience to parkers. We will post notices with the dates and times, so residents know what to expect when they are coming and going from the garage when work is underway.
ALSO IN THE GARAGE, workers have been repairing some areas of the membrane on 1p that has deteriorated. This location is also in the picture above. Protecting the concrete below is important to keep in from developing divots and potholes, or causing leaking into 2p below. We expect this work to be completed next week.
7. Weather permitting, Plaster Repairs will continue to the Canopy in front of the building, right under the corner behind the doorman, which was tied off by caution tape for several weeks. This area was damaged in high winds during a Spring storm. The necessary work is very wind and temperature sensitive, which has prevented us from making progress this week.
Fortunately, our team got a window of opportunity to prep the location and remove the conditions we believed were in a precarious state warranting the caution tape. So that has been removed for now. We continue to await more temperate and less windy weather to complete this repair.
The ’02/’04 High Zone Riser Project is wrapping up, but on its heels, at the end of May, we’ll be beginning the ’14/’15 Low Zone Riser Project. Work will continue through early July. Residents between the 3rd and 29th floors will see workers coming and going from the ’14 and ’15 units as their kitchen riser is being replaced.
Also, we’ll begin our project to remodel the health club washrooms and locker rooms around mid-May. Demo is actually expected to begin Monday May 15th. The project may take about 7 to 9 weeks once it gets underway. During the course of that project, we also hope to replace our pool liner. There will be times when access to the health club will be limited, and we expect the pool to be closed for about 4 weeks once work gets underway.
While work is underway, there will be noise during business hours. Typical construction noise, drilling, pounding, grinding may be heard in the lobby, mall, commercial suites and lower floors in the tower. It will probably be the heaviest and worst during the first week beginning May 15th. Demo is always the loudest part.
ALSO, we will be completing masonry repairs and tuckpointing on the North and East exposures of the building. That is expected to begin within a couple weeks weather permitting. Between now and then, our team will be sitting down with the contractor to review a timeline. Traffic in our driveway and around to the back dock will be impeded, and parking for unloading and loading in the back may be inconvenient at times when workers are present. Once we have a timeline, we will share it with residents.
Also outdoors, we will begin phased replacements of planter liners on our roof deck. First up, the two North and Easternmost planter liners will be replaced. This is the ‘serpentine’ shaped planter immediately on the left as you walk out on to our 2nd floor roof deck, the round planter with the tree in the middle all the way at the East end of the deck. Both these planters have had problems with leaking and irrigation over the past year. Sadly, we will be saying goodbye to some of our trees. We have been advised some are so big, they could be causing some of our planter issues. But, there is no other way to do the work we need to do than to remove them.
Back inside, through the lobby, mall, 2nd floor, 1p, 2p and garage, workers will be upgrading our Security System. Every camera in the building and its wiring is being replaced, as we overhaul the analog/digital mishmash we have now, to a more state of the art digital HD system. Cameras are also being added in a few locations, mostly in the health club, garage and a couple locations in the mall, for better protection and to improve coverage of critical areas. This process is also expected to begin in May, and May take about 60 days to complete.
The key fob system is also being upgraded, but we expect minimal interference with how you enter the security doors. We are changing the software we use, and when that is done we expect a window of time during business hours when the readers will be down. Once we know the dates, notice will be posted and we will coordinate with the staff to help make sure everyone is able to get in and out as needed. Fortunately, the fob data is compatible with the new software, so there should be no need to replace fobs or reprogram them.
In the garage, the emergency fire doors will be replaced. You would recognize these by the big silver protective enclosures which are located at key thresholds throughout the garage, to help prevent the spread of smoke and flames in the event of a fire or explosion. These have been ordered, but are custom made so it may be several weeks before this project can begin in earnest. We are planning to do the bulk of the installation work overnight, to minimize the interference with traffic coming through these thresholds.
Coming down the pipe? Replacement of our main roof is schedule for this budget year. The Association is reviewing bid specifications, and is gearing up to put the project out to bid. Originally scheduled for mid-summer, this project is now expected to take place toward the beginning of fall to accommodate additional work we now expect to do to improve our safety tie-back system. To learn more about this, read our Post Meeting Roundup For April 24th.
Our team will work as hard as possible to minimize inconvenience to our residents and keep you informed throughout the process. It is ultimately our goal to maintain a positive living experience and protect owners investments in Park Tower. These projects are aimed at improving security, residents well being, and making needed repairs to our infrastructure. We sincerely appreciate your patience and understanding while work is underway, and apologize in advance for any headaches you might experience as a result.
Feel free to write me with any questions or concerns, just shoot us an e-mail.
